Undergrounding at PG&E

Undergrounding and system upgrades

Improving wildfire safety and reliability for our customers

View our wildfire safety progress map to see where this work is happening.

Undergrounding & system upgrades

PG&E is working to install thousands of miles of powerlines below ground in high wildfire risk areas. We are also upgrading our electric system by installing strong poles and covered powerlines. This work will help keep customers and communities safe.



How we determine where to complete wildfire safety work

PG&E uses a risk model to determine where to complete wildfire safety work. This risk model tells us which areas we serve are at the highest risk of wildfires. The type of improvement we make depends on terrain, vegetation, weather patterns and more.


The types of system improvements we consider include:



  • Moving powerlines underground
  • Installing strong poles
  • Covering powerlines
  • Trimming trees

These are just some of the layers of protection that help keep customers safe. Learn more about our other layers of wildfire protection. Visit PG&E's Community Wildfire Safety Program.





Benefits of undergrounding for wildfire safety

Our undergrounding efforts involve moving sections of powerlines below ground. This eliminates nearly all wildfire ignition risk from that line. It also improves reliability.



Undergrounding is safe, strong and more cost-effective in the long term. This proven process:



  • Reduces nearly all wildfire risk in a given location
  • Improves reliability and limits outages
  • Decreases the need for future tree and vegetation work
  • Lowers maintenance and operating costs



important notice Note: After we complete this work, customers will continue to see other equipment overhead. In most cases, this includes telephone lines or lower-voltage powerlines connecting to individual homes or businesses.

Benefits of system upgrades for wildfire safety

We are upgrading overhead poles and powerlines to reduce wildfire risk. We describe these changes as system upgrades, or overhead hardening. This work reduces ignition risk by nearly 64% on a line once completed. When used with other wildfire safety tools, additional risk is reduced. It is also a useful tool in areas where powerlines cannot be moved underground.



These efforts are targeted in high wildfire-risk areas and can include:



  • Replacing bare powerlines with strong covered powerlines
  • Installing strong poles
  • Installing more poles to support the weight of covered powerlines
  • Removing overhead poles and lines that are no longer needed



important notice Note: After we complete this work, customers may also see remaining poles for phone, internet or other electrical lines.

What can I expect during this work?

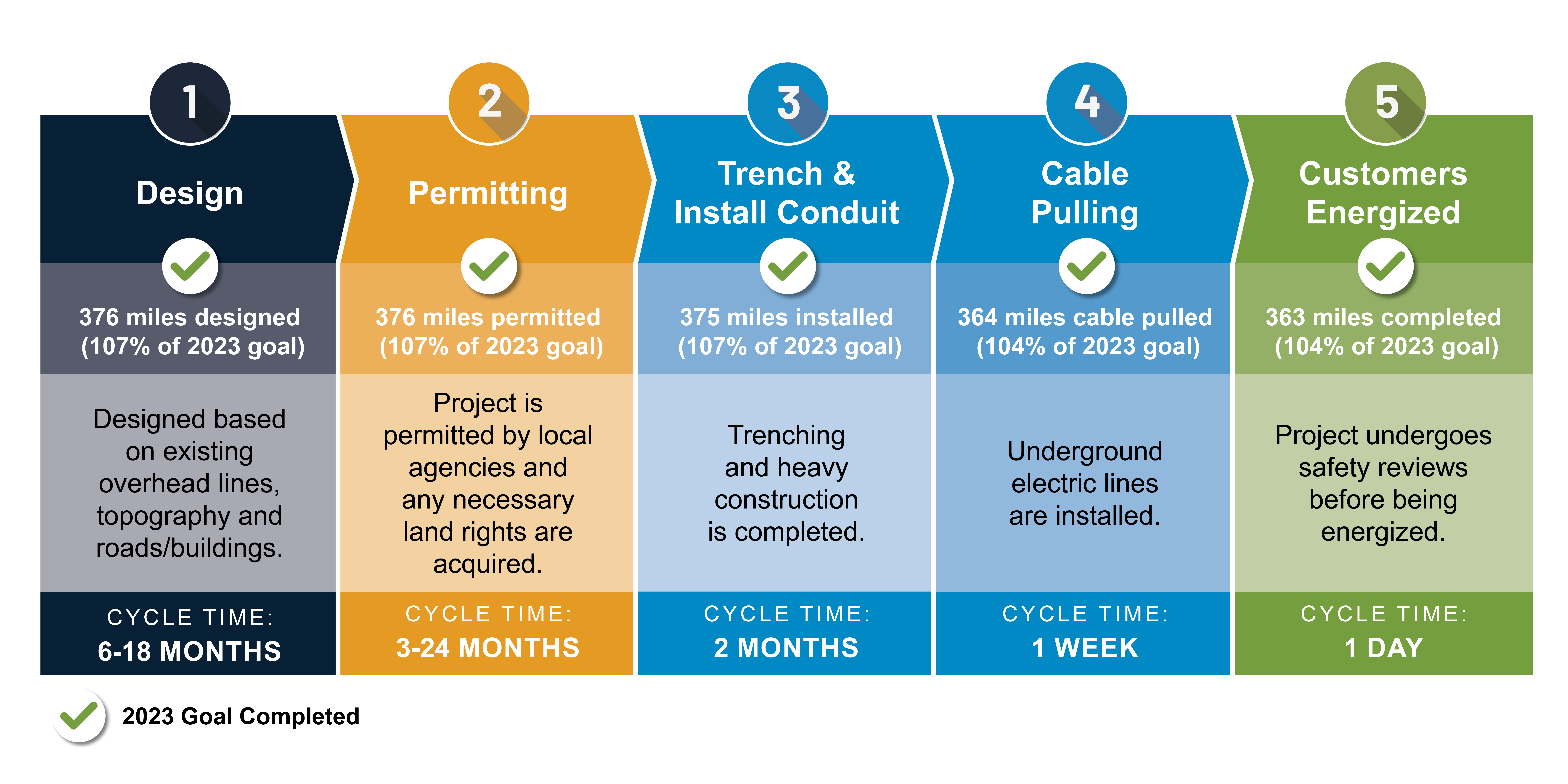

We will keep you informed if we identify your area for wildfire safety work. Projects that include moving powerlines underground typically take 12 to 24 months to complete. The installation of strong poles and covered powerlines typically takes 6 to 18 months to complete*.



In your neighborhood you may see:

Phase 1: Scoping and surveying

Crews walking your neighborhood to identify and mark potential project routes. This includes survey crews painting and staking.

Phase 2: Design

PG&E representatives meeting with property owners about easements. Performing soil samples and inspecting vegetation.

Phase 3: Pre-construction preparation

Crews trimming or cutting down trees and shrubs and construction to install new equipment. Traffic control measures will be in place to keep you safe.

Phase 4: Construction and planned outage

PG&E representatives working to install and energize upgraded powerlines. Your power may need to be turned off for a short time to complete this work safely.

Phase 5: Post-construction

Work to restore the area and removal of any remaining construction equipment or materials.

Phase 1: Scoping and surveying

Crews walking your neighborhood to identify and mark potential project routes. This includes survey crews painting and staking.

Phase 2: Design

PG&E representatives meeting with property owners about easements. Performing soil samples and inspecting vegetation.

Phase 3: Pre-construction preparation

Crews trimming or cutting down trees and shrubs and construction to install new equipment. Traffic control measures will be in place to keep you safe.

Phase 4: Construction and planned outage

PG&E representatives working to install and energize upgraded powerlines. Your power may need to be turned off for a short time to complete this work safely.

Phase 5: Post-construction

Work to restore the area and removal of any remaining construction equipment or materials.

* Phases 1 through 3 may take 1 to 18 months. Phases 4 and 5 may take 2 to 3 months each.

important notice For your safety, all crews and contractors conducting this work are happy to provide photo ID on request.

Learn more about our wildfire safety work



Undergrounding for public safety

Customer and community resources

* Data as of January 13, 2025. Some undergrounding projects include associated system upgrade mileage. This map is for illustrative purposes. Forecasts can change as our risk model evolves to address the greatest wildfire risk. Forecast miles also exceed annual targets. Mileage in a community may increase or decrease due to access, weather, permitting or other constraints. In most cases, if a project is not completed during the year originally identified, it will continue through planning/construction phases during subsequent years. Mileage represents projects that will be energized in a given year. Construction for a project may begin before the year of energization and final property and road restoration work may occur after the year of energization.

Frequently asked questions

See our progress and future plans

Data as of 1/13/2025



Since launching our 10,000-mile undergrounding program in 2021, we have:



  • Constructed and energized more than 875 miles of underground powerlines
  • Completed this work on time and on budget
  • As of December 16, 2024, we reached our goal of moving 250 miles of powerlines underground in 2024.



View planned and completed undergrounding on the wildfire safety progress map.



Undergrounding power lines progress thermometer

    System upgrade progress



    Data as of 01/13/2025



    We have installed 1,300+ miles of strong poles and covered powerlines since we launched our Community Wildfire Safety Program in 2018. As of December 16, 2024, we reached our goal of installing 70 miles of strong poles and covered powerlines in 2024. In some cases, this work included limited line removal.



    View planned and completed system upgrades on the wildfire safety progress map.
